__________________________________________________________________
2019 – 2025: 2. S-Bahn Core Route, Munich
To relieve passenger traffic of the existing main line, a second approximately 11 kilometres long main line is being built between Laim station in the west and Leuchtenbergring station in the east. The centrepiece is a seven kilometre long tunnel connecting the newly to-be-built underground stations Hauptbahnhof and Ostbahnhof, with the underground station Marienhof located in between.
For technical details and information on construction progress, please refer to the official DB website for the project:
https://www.2.stammstrecke-muenchen.de/startseite.html
(-> "EN")
Services:
- 2021 – 2025: Team Leader of DB (German Rail) for contract management and
project control / coordination at section Marienhof
- 2019 – 2020: Contract and claim / variation management for the external
engineering consortium in charge of the construction supervision at
section Marienhof
Section Marienhof:

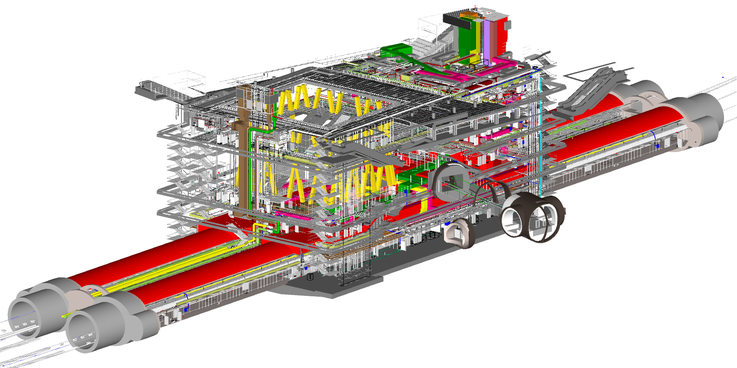

Axonometry of the diaphragm wall box constructed using the cut-and-cover method and the four tunnels for the platform levels. In front: the pedestrian tunnel to the existing subway. All tunnels are being built using the mining method.
____________________________________________________________________________________________________________________________________
2012 - 2013:
BUDAPEST METRO 4, CONTRACT-09: "Integrated Systems, Power
Supply System"
FIDIC (Fédération Internationale des Ingénieurs Conseils) Yellow Book Contract
- Expert report / qualification for the contractor answering the questions raised by
the Arbitral Tribunal with regard to an extension of time / disruption claim
__________________________________________________________________
2006 - 2011:
SECTION U3 NORTH3, Moosach, Germany
Crossing station of German Rail with subway line U3 including a subterranean two story car park and storage sidings
Scope of Construction:
Upfront a sewer was deviated out of the area of the underground car park by means of 86m of pipe jacking (DIN 1200) under the Station of German Rail.
The substructure with a length of 360m length consists of a two story underground car park and a storage siding for the subway underneath. The structures were built whilst at any given time three out of the five tracks of German Rail were in service. Thus German Rail tracks had to be deviated twice and island sites had to be managed.
The walls of the structure were built of single-leaf diaphragm walls (1,20m) and both vertical and inclined (O.D. 1,50m) intersecting bored piles. After excavation at the piles a facing concrete was applied. The restraint length of the walls in the ground necessitated diaphragm walls and bored piles with a length of up to 30m. Due to tight development around the site the top slabs could partly be concreted only in portions, because the road traffic had to be deviated several times. After dewatering of the trough structure, excavation was conducted in two stages. First it was excavated down to the second slab of the car park. After this slab was concreted, excavation down to the base plate was done. During that excavation in part horizontal temporary strutting was installed between the tunnel walls to support the structure for lateral earth pressure.
The tunnel structure stands rectangular to the ground water flow. In order to balance the water levels up and downstream five pairs of shafts were built from bored piles outside the structure and connected with pipes running through the slabs of the car park.
Services:
- Engineer, contract administration and quantity surveillance for structural and
architectural works until subway line U3 went into service and all contract
close-outs were performed, respectively.
Photo above: Feeding of rebar cage for diaphragm wall
Photos below: Inclined bored piles next to existing buildings
Boring piles on the island site between tracks of German Rail
__________________________________________________________________
Photo above: Reinforcing top slab of ticket hall on the island site
Photos below: Intermediate slab portion of car park
Inclined bored piles with bearing pockets for intermediate slabs
__________________________________________________________________
Photos below: Core drilling through diaphragm wall for piping of ground water shaft
Start second excavation stage for storage sidings
Excavation ticket hall with temporary propping
__________________________________________________________________
Photos below: Installation and jacking of auxiliary strutting
Photos above: Works underneath the strutting
Ground freezing
__________________________________________________________________
Photos below: Track works at German Rail
Shuttering works at ramp for car park
Photos above: Reinforcing top slab of ramp
Ramp before opening
__________________________________________________________________
Photo below: Final works storage sidings
Test runs of subway before service date
__________________________________________________________________
2005 - 2009: SECTION U6 NORTH 7, Garching, Germany
Construction of the station "Garching Forschungszentrum" with adjacent lines
- Engineer, commercial close-out of main construction works
- Check of the final invoice of the VOB-Contract
- Assessment of variations and claims
- Preparation of technical expert reports for an insurance coverage claim at court
and an extension of time / disruption claim at court
__________________________________________________________________
2003 - 2007:
SECTION U1 WEST 8, Munich, Germany
Construction of the subterranean crossing station (Lines U1 and U3) "Olympia-Einkaufszentrum" with adjacent tunnels
- Commercial Close-out of main construction works
- Check of the final invoice of the VOB-Contract
- Assessment of variations and claims
- Preparation of an extrajudicial agreement on a disruption claim
- Assessment of owner's entitlement to rectification works of contractor regarding
leakages at the single-leaf diaphragm walls
__________________________________________________________________
1999 - 2001: PUSAR ULAK, Brunei
Technical Project Manager
- Final design of the tunnel structure under a highway built with prestressed
concrete and utilizing the cut and cover method
- Technical support of the site during construction
__________________________________________________________________
